Villa Development | Rebar Bending Schedule & Quantity Takeoff

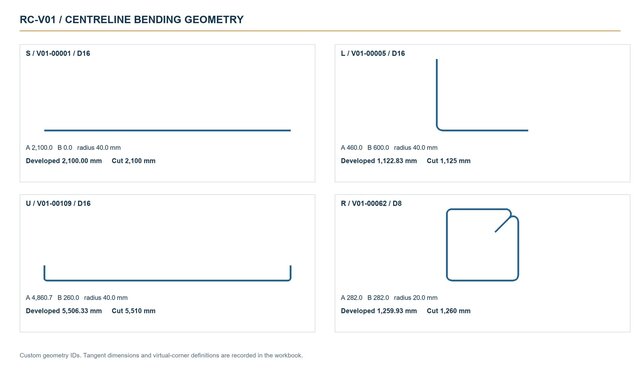

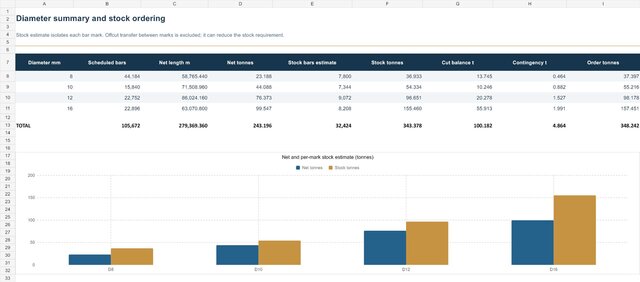

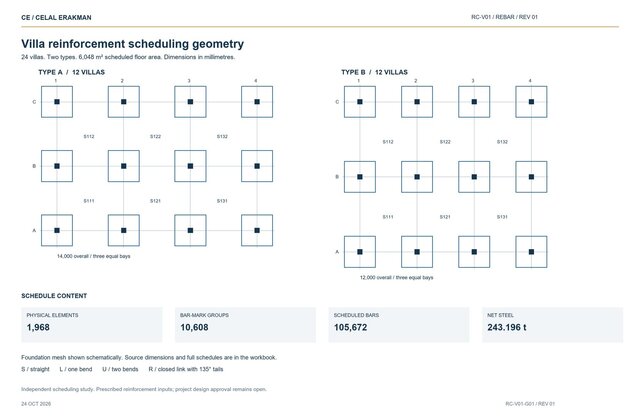

RC-V01 reinforcement scheduling for a 24-villa development: two repeated types, 6,048 m2 scheduled floor area, 1,968 physical elements and 10,608 bar-mark groups. The nine-sheet Excel workbook calculates 105,672 scheduled bars and 243.196 tonnes of net reinforcement. It links editable geometry and controls to bar quantities, centreline bend lengths, rounded cut lengths, weights, diameter procurement and villa/pour releases. Includes native filterable registers, a stock comparison chart, bending diagrams, CAD scheduling geometry and validation results. All 10,608 scheduled rows were checked for quantities, cut lengths and mass. Independent polyline geometry checks, input-change tests and nine reconciliation controls passed. Stock estimates cut each mark separately and include trim/offcuts; cross-mark reuse is excluded. Independent scheduling portfolio study. Reinforcement is prescribed input and project design approval remains open. Scope and geometry conventions are recorded in the workbook.
quantity-takeoff rebar-detailing
